Condition Assessment & Indicative Value Range
The risk and value picture before you commit · Block 36, Lot 16, Frontiera Subdivision, Camella Gran Europa, Brgy. Lumbia, Cagayan de Oro City

1Executive Summary
The house appears structurally sound, with significant deferred maintenance. Two items need action before anything cosmetic: the roof fascia and eaves, and the electrical service entrance. Priced correctly and renovated in the right order, this is a workable purchase. Priced at the top of the range, the numbers get thin.
| Key figure | Result |
|---|---|
| Overall condition | Structure appears intact; significant deferred maintenance |
| Ownership status | Mortgaged to Pag-IBIG; payoff and title transfer covered in Section 7 |
| Renovation estimate | ₱800K – ₱1.7M for six work packages, before contingency |
| All-in cost to move-in ready | ₱6.4M – ₱8.5M (purchase price plus renovation budget, before transfer costs; see Section 5) |
| Indicative renovation duration | 10–14 weeks, sequenced (Section 4) |
✓Our Answer: Proceed at ₱3.7M?
At ₱3.7M plus the ₱880K – ₱2.0M renovation budget, your all-in cost is ₱4.58M – ₱5.70M before transfer costs. That sits at or below the indicative as-is range (₱5.5M – ₱6.5M) and well under the move-in-ready value (₱7.0M – ₱8.0M). The structure appears intact; what we found is repairable deferred maintenance, not a defect that changes the buying decision.
- Confirm what ₱3.7M covers. It should be the total consideration, including the Pag-IBIG payoff, with the payoff and payment split written into the contract (Section 7).
- Verify the two urgent items first. Have the roof and fascia and the electrical service entrance checked by specialists before you sign (Section 8). Their findings may move the renovation budget.
- Confirm a clean title. Check the TCT for any encumbrance other than the Pag-IBIG mortgage.
- Hold the budget. Keep the 10–15% contingency and budget transfer taxes and fees separately.
This is our professional view based on a visual inspection, not a valuation or a guarantee. If the verifications or the title check turn up a structural or legal problem, we will revisit the answer with you.
2Property Details
| Item | Detail |
|---|---|
| Property | Two-storey single-detached house and lot |
| Address | Block 36, Lot 16, Frontiera Subdivision, Camella Gran Europa, Brgy. Lumbia, Cagayan de Oro City |
| Developer / enclave | Camella (Vista Land & Lifescapes); Frontiera, the Mediterranean-themed enclave |
| Lot area | 120 sqm (verified measurement) |
| Floor area | 165 sqm (verified measurement) |
| Layout (observed) | 3 bedrooms, 2 comfort rooms, garage for one pickup truck |

| Inclusions (observed on site) | Daikin inverter split-type aircons in all rooms plus living and dining (see Photo 17); internet connection. List everything that stays with the sale in the deed. |
| House model | Camella Gran Europa, Frontiera (confirmed with developer) |
| Seller | John Michael Duhaylungsod-Morin |
| Ownership | Mortgaged to Pag-IBIG Fund; outstanding balance of approximately ₱1.0M, to be confirmed by a Pag-IBIG statement (Section 7) |
Floor and lot areas were measured on site on 27 September 2026 and are the basis for the comparables and value range in Section 5. The lot area will also be matched against the title (TCT) during document verification.
3Condition Findings
The house shows the Camella Mediterranean style: cream exterior walls, red tile roofing, decorative balustrades, and red accent columns. The main structure appears intact. Weathering and water damage are visible throughout.
Observations by area
| Area | Observation |
|---|---|
| Structure | Walls, columns, and roof framing appear intact on visual inspection |
| Front façade | Retains its architectural character; paint is faded and weathered |

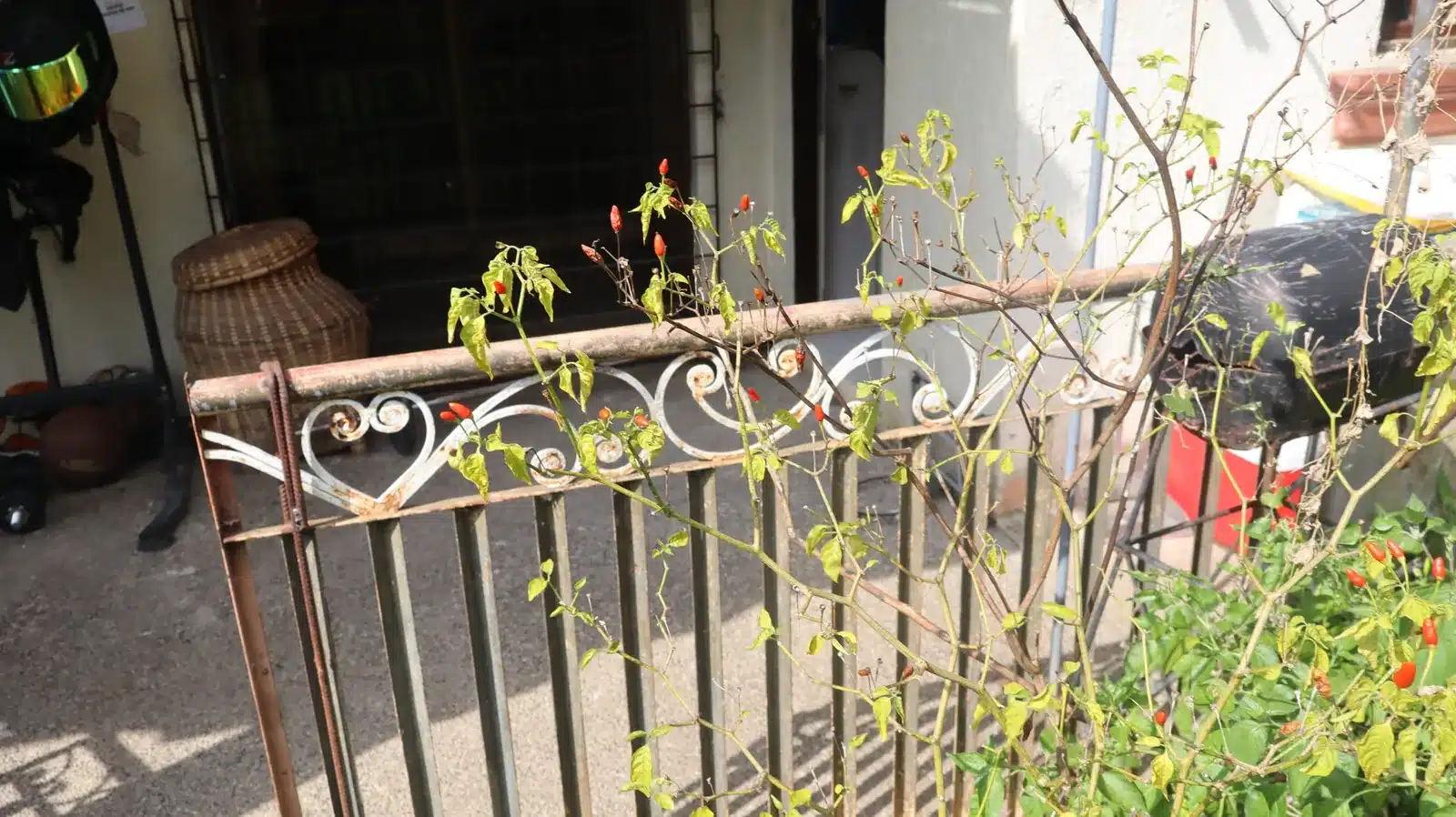

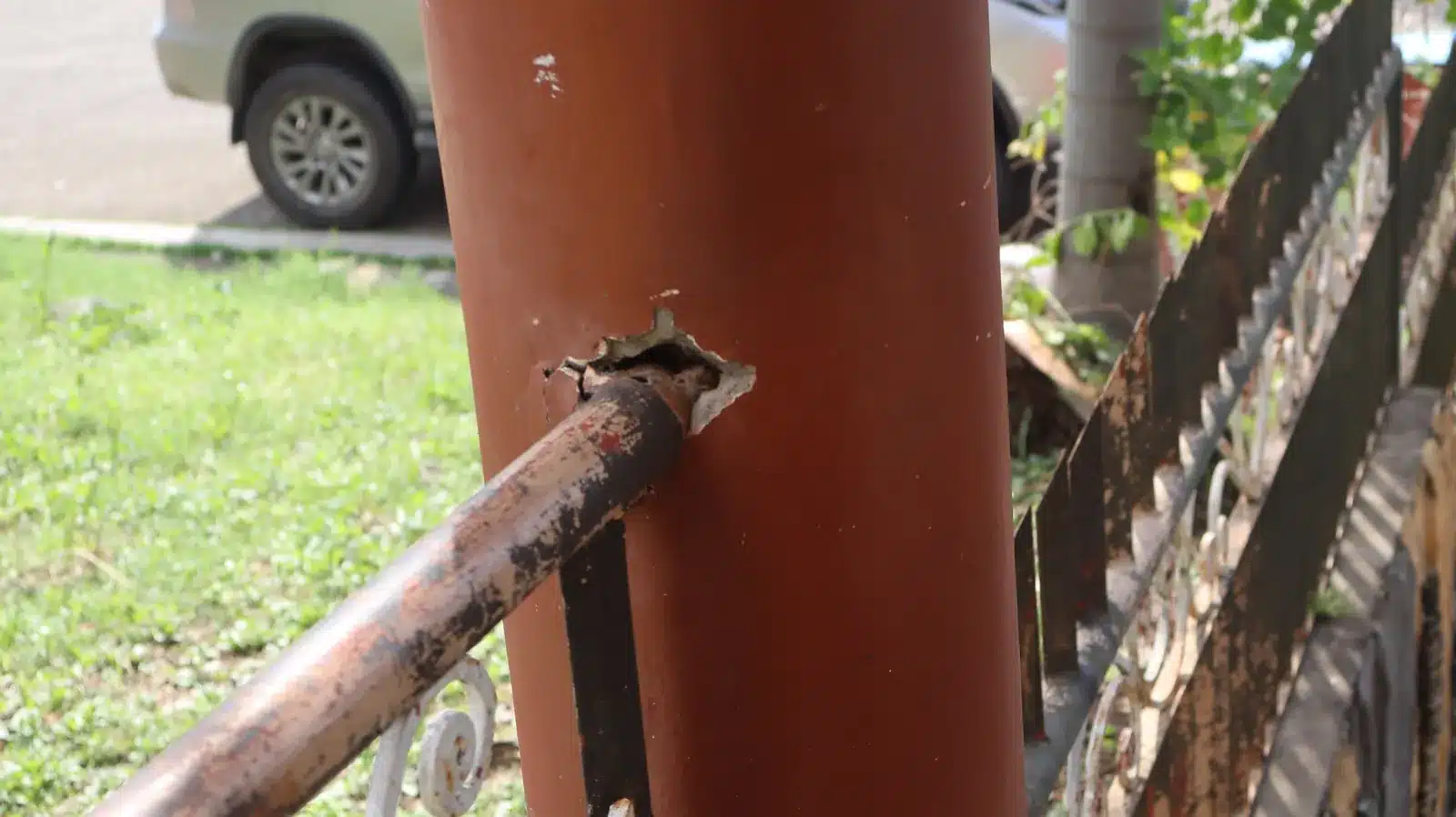

| Railings and gates | Wrought iron is functional but heavily weathered, with surface rust |
| Perimeter fence | Serves its purpose; significant oxidation, needs treatment and repainting |

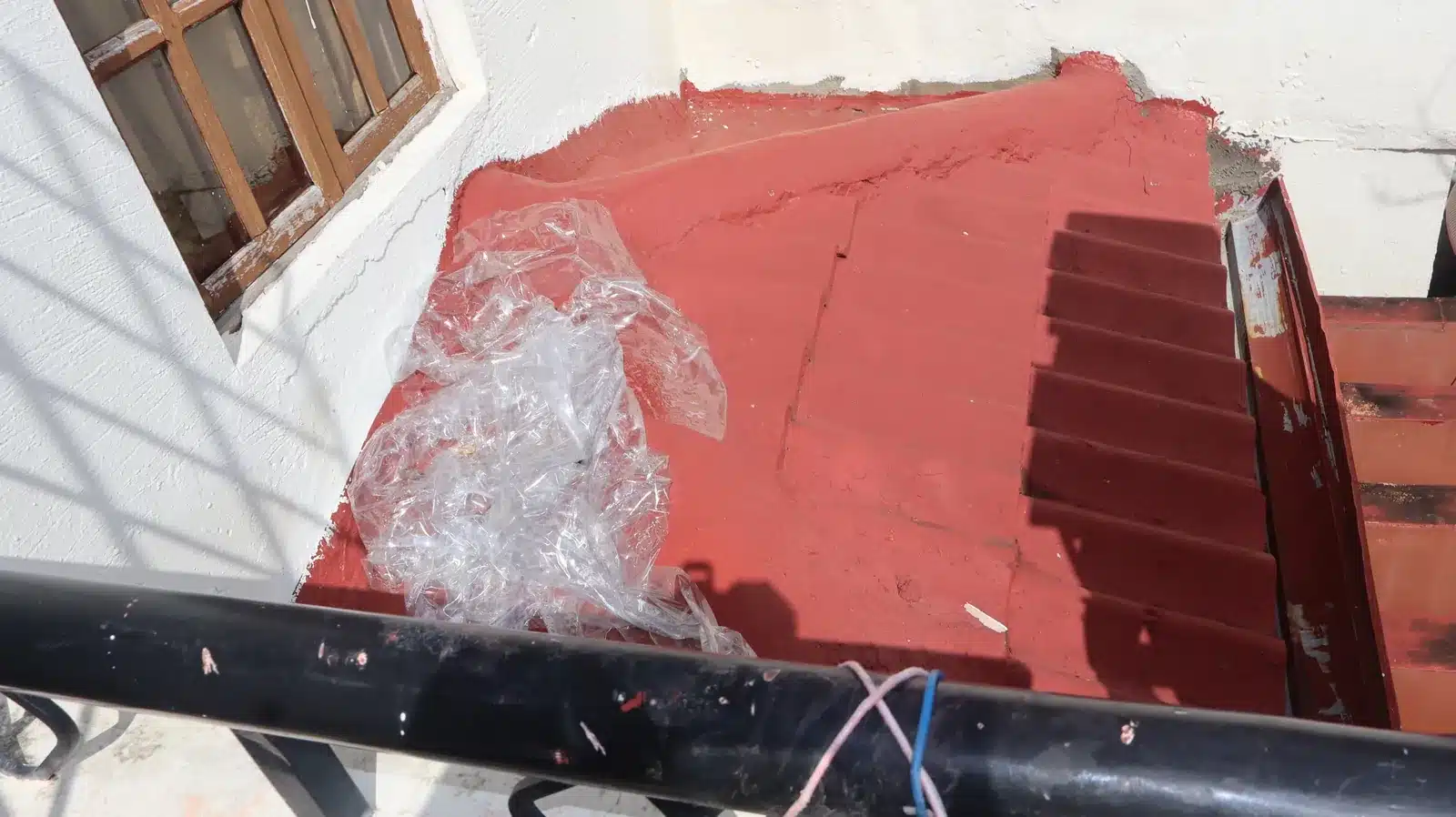

| Roof tiles | Intact; surface staining and moss growth |
| Fascia and roof edges | Visible deterioration and water damage; the most urgent exterior concern |
| Ground floor | Living and dining areas, kitchen to the rear; white ceramic tile flooring |
| Second floor | Bedrooms and bathrooms; herringbone wood parquet, a distinctive feature that adds character |
| Ceilings | Decorative coffered ceilings with dark trim accents |

| Kitchen | Concrete base cabinets with painted wooden doors and a stainless steel sink; standard Camella finishes |
Damage and risk register
Two items need action now. The rest can be scheduled into the renovation in the sequence shown in Section 4. Photo references point to the site photographs below.
Roof and fascia

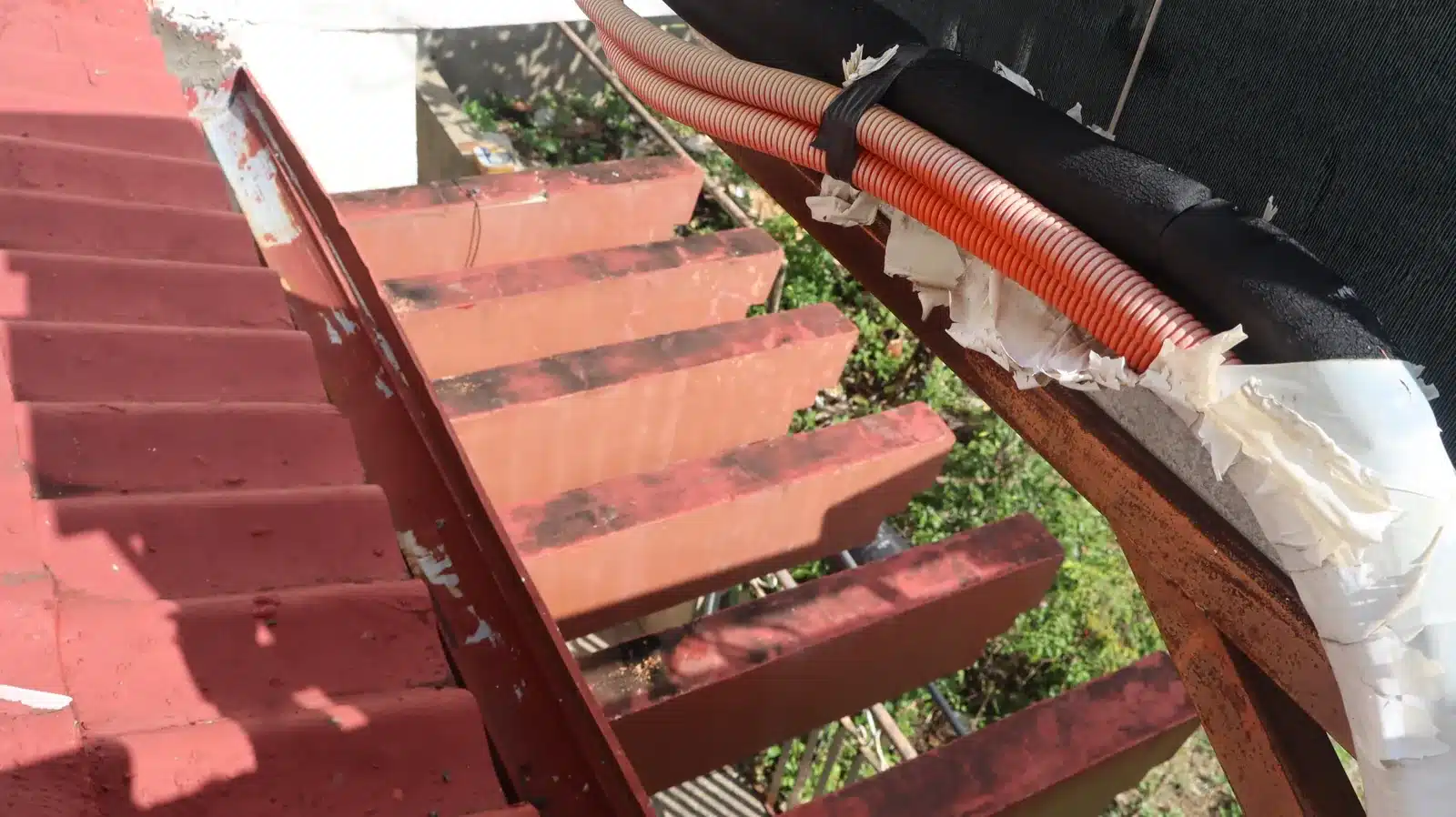

- Finding
- Rot and decay in fascia boards and wooden roof framing near the eaves. Tiles are intact, but the supports show advanced water damage. Real risk of water entering the house in the wet season.
- Action
- Repair before the rainy season peaks to stop further interior damage. Extent of hidden framing rot to be confirmed on opening up.

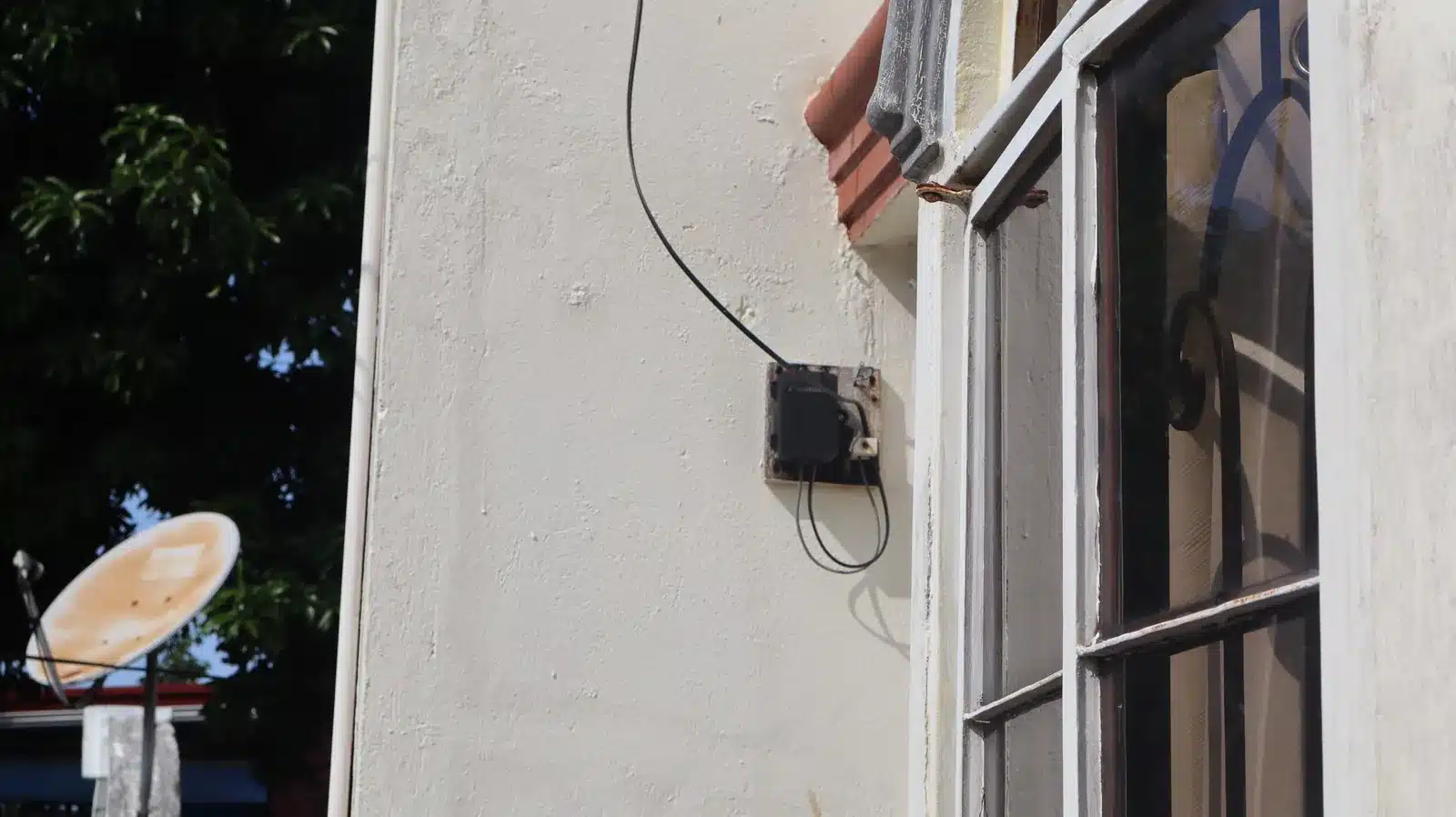

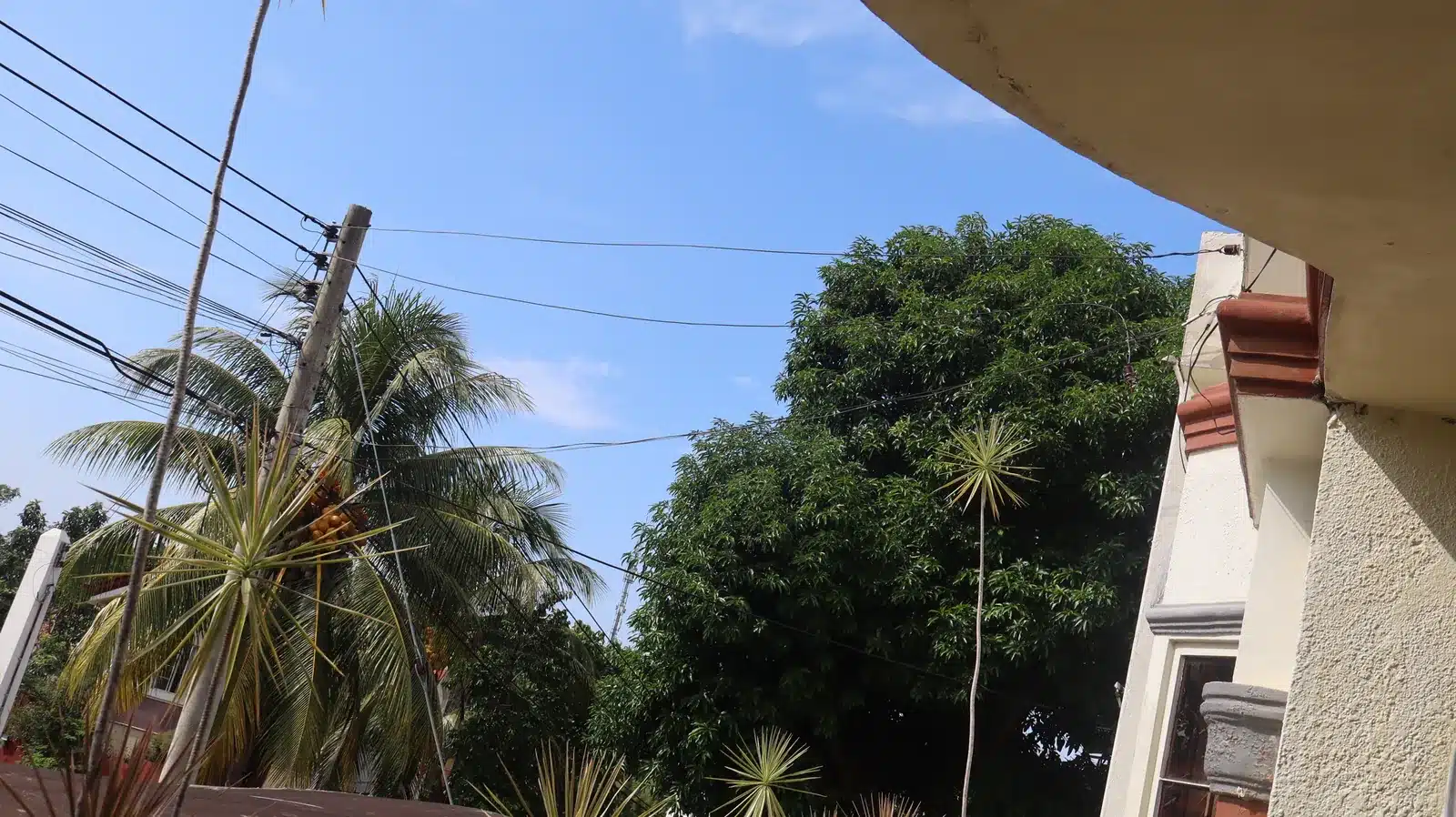

Electrical service entrance
Photos 4–6- Finding
- Service drop, meter base, and wiring appear inconsistent with Philippine Electrical Code requirements: exposed wires and a poorly secured entrance. This is a shock, fire, and outage risk.
- Action
- Verification and correction by a licensed Registered Master Electrician (RME). Treat as a safety item, not a cosmetic one.
Water damage and ceiling stains

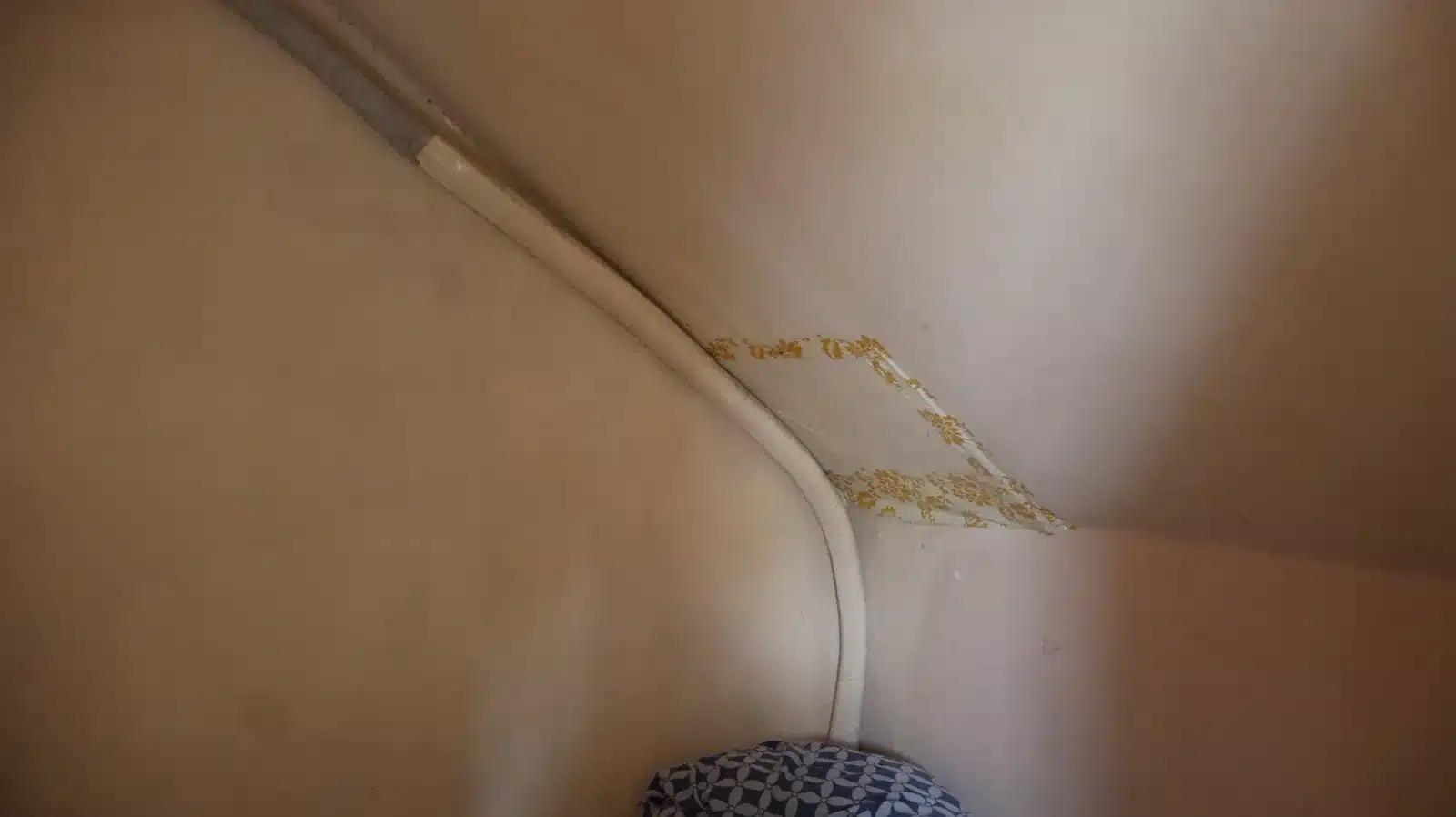

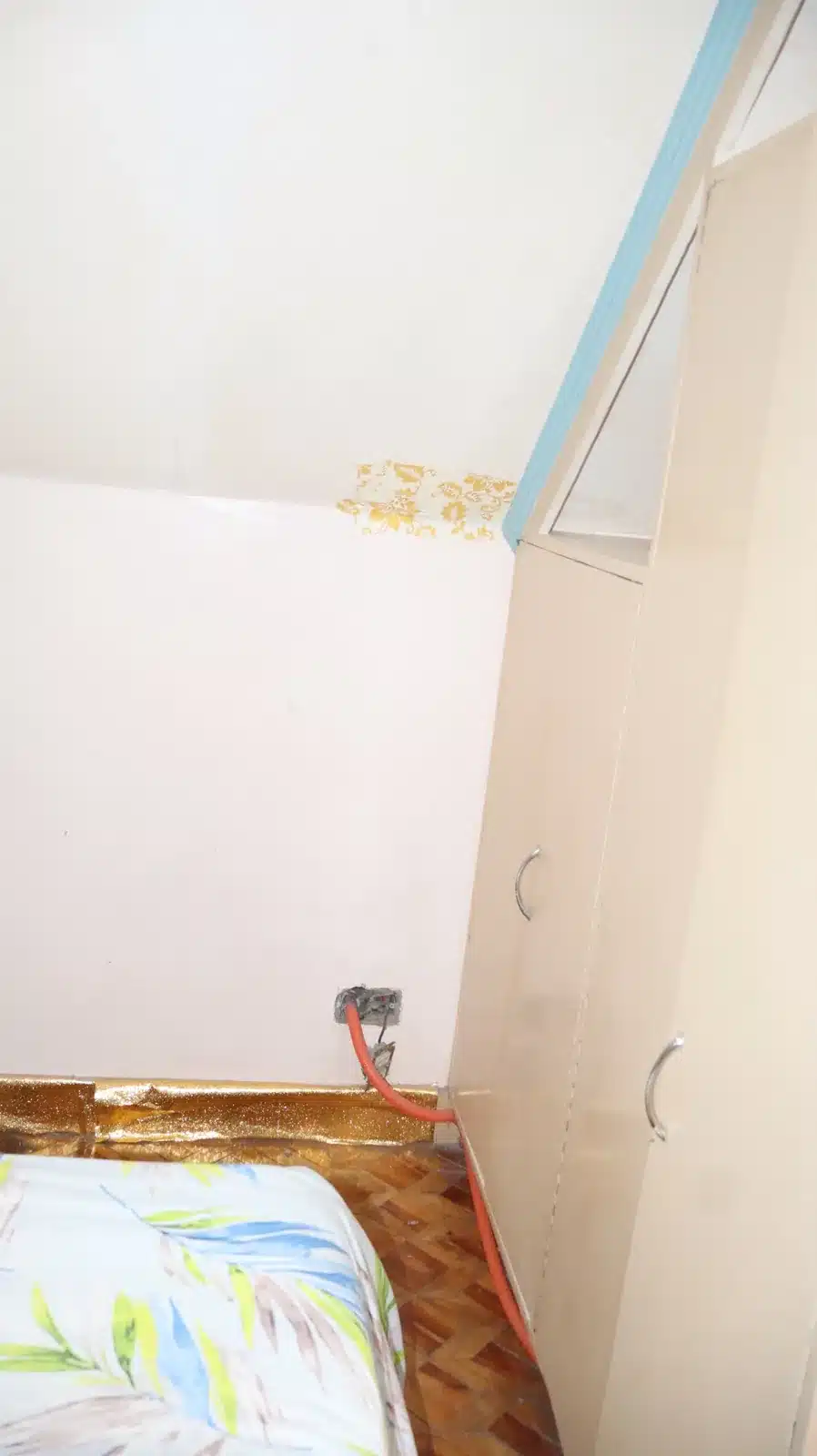

Photos 1–3- Finding
- Stains, bubbling paint, and discoloration on ceilings of both floors, pointing to past or ongoing leaks around roof valleys and eaves.
- Action
- Fix the roof first, then repair and repaint ceiling finishes.
Bathrooms
- Finding
- Heavily stained, aged fixtures; discolored bathtub; darkened grout. Possible moisture issues.
- Action
- Renovate finishes; pressure-test plumbing for leaks or corrosion.

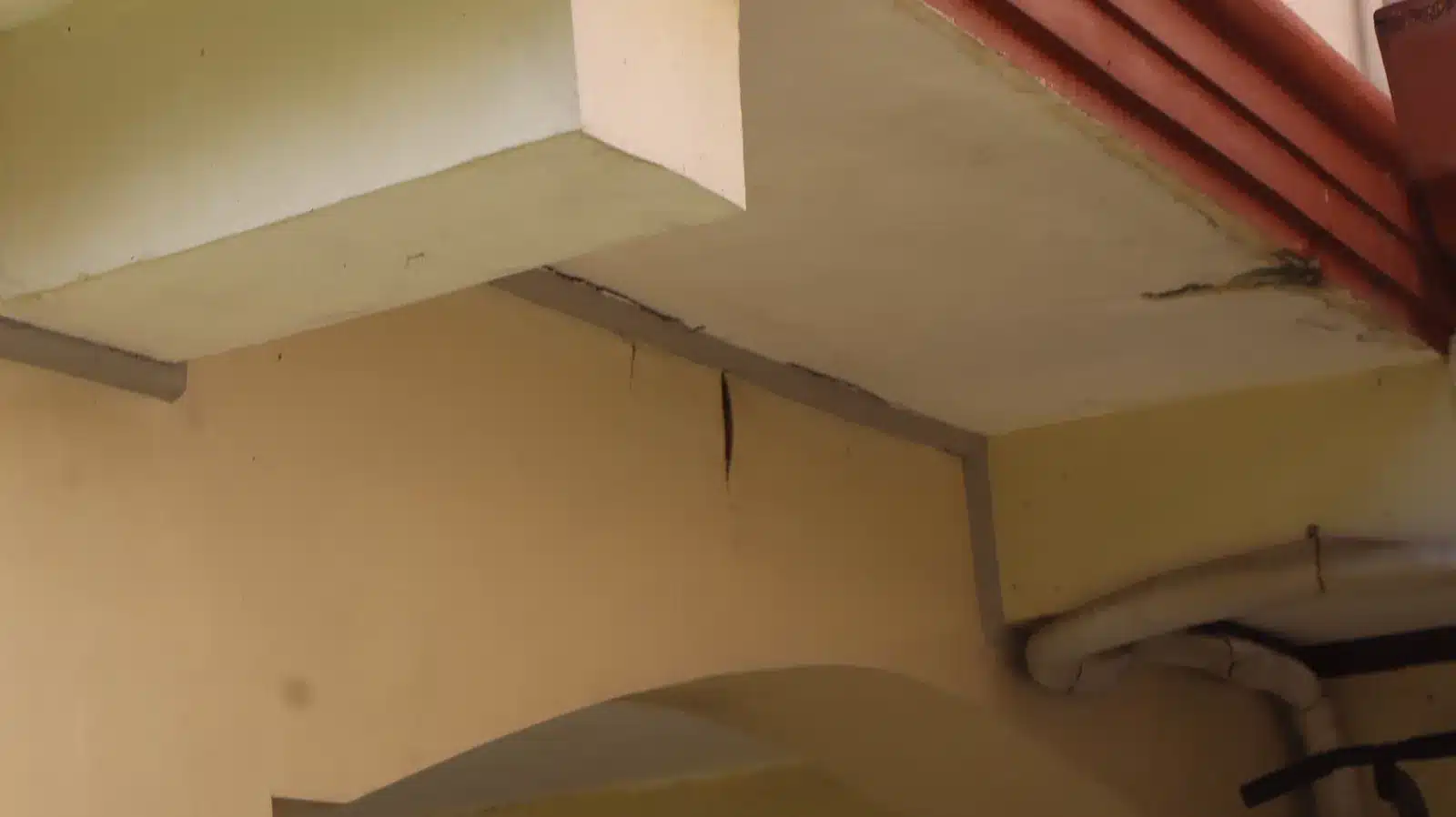

Wall cracks
Photo 1- Finding
- Hairline to moderate cracks in interior and exterior finishes. Most appear to be cosmetic settlement cracks.
- Action
- Structural engineer to verify larger cracks, especially near load-bearing beams or arches.

Termite and moisture damage
- Finding
- Termite frass and rot on interior wooden door frames, near bottom edges and floor junctions.
- Action
- Termite treatment; replace affected wood members.
Paint and finishes
Photos 7–12- Finding
- Faded and peeling exterior paint; scuffs and peeling on interior walls near ceilings and baseboards.
- Action
- Full repainting, done last.
Utility areas

Photos 13–15- Finding
- Cluttered and weathered carport, laundry, and utility spaces; stained, aged polycarbonate carport roof.
- Action
- Clean and reorganize; consider new roofing material.
Site photographs
Taken during the 27 September 2026 inspection. Captions describe what is visible; they are observations, not diagnoses.

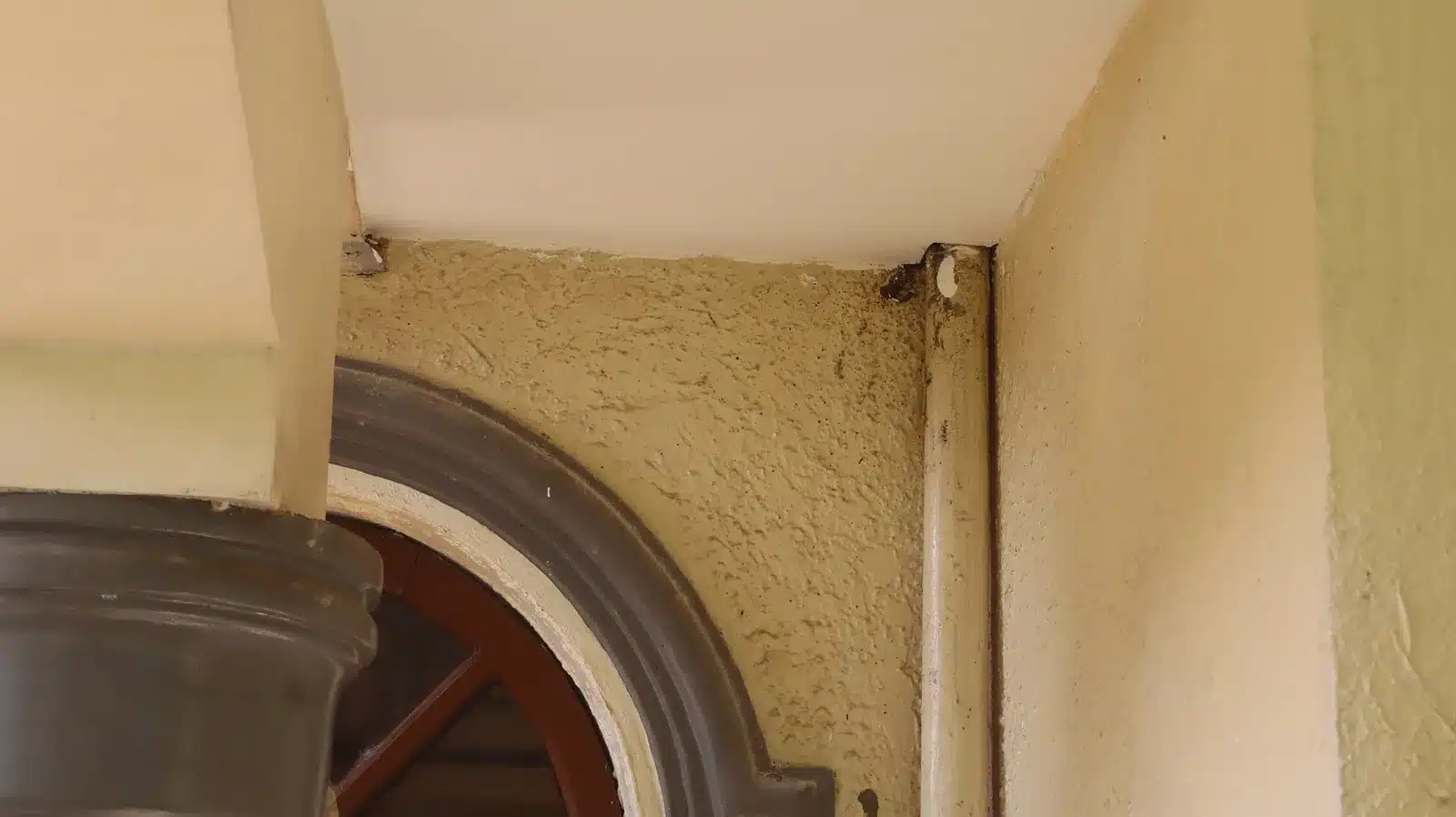

The site visit

Water staining and cracking

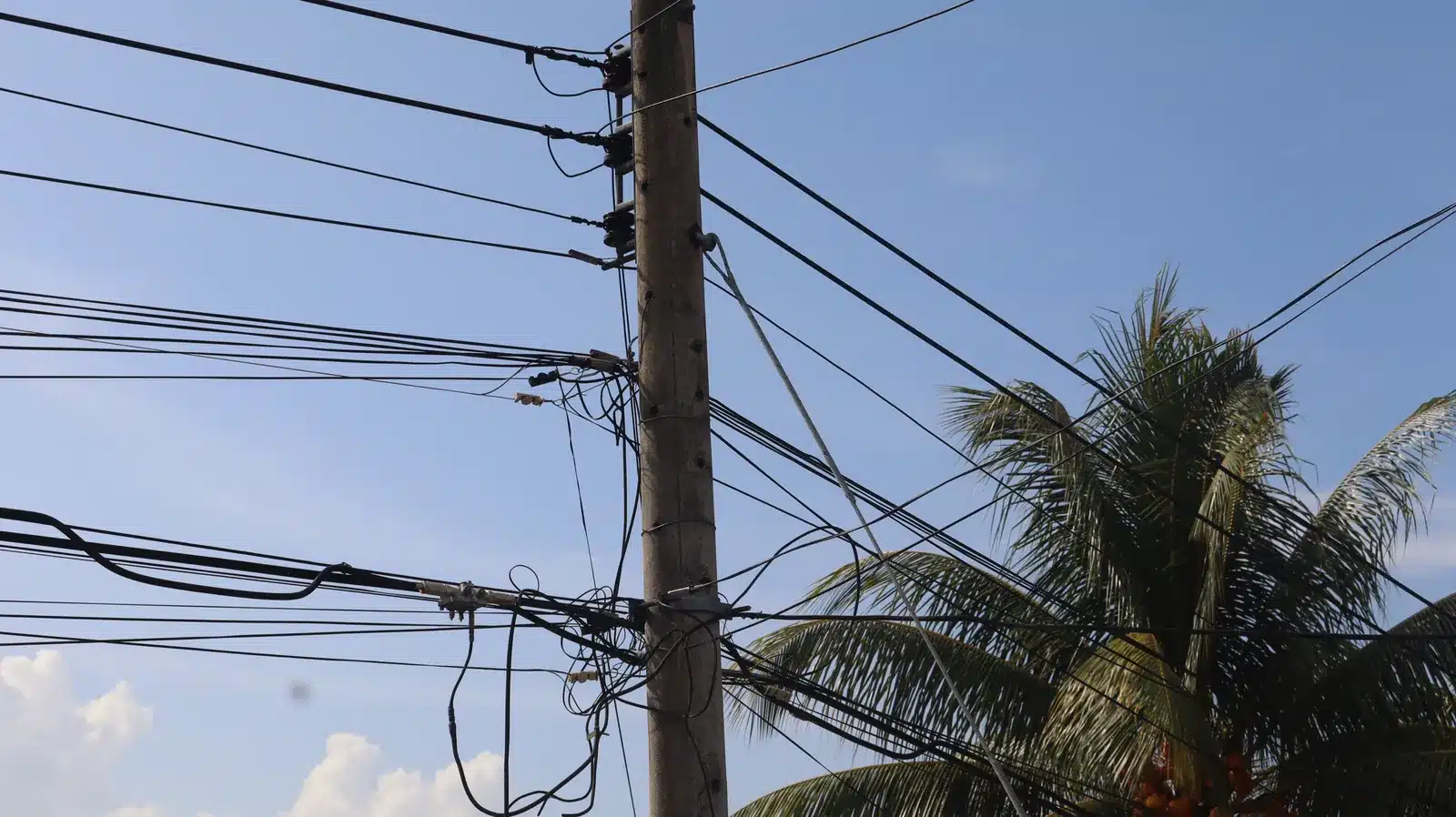

Electrical

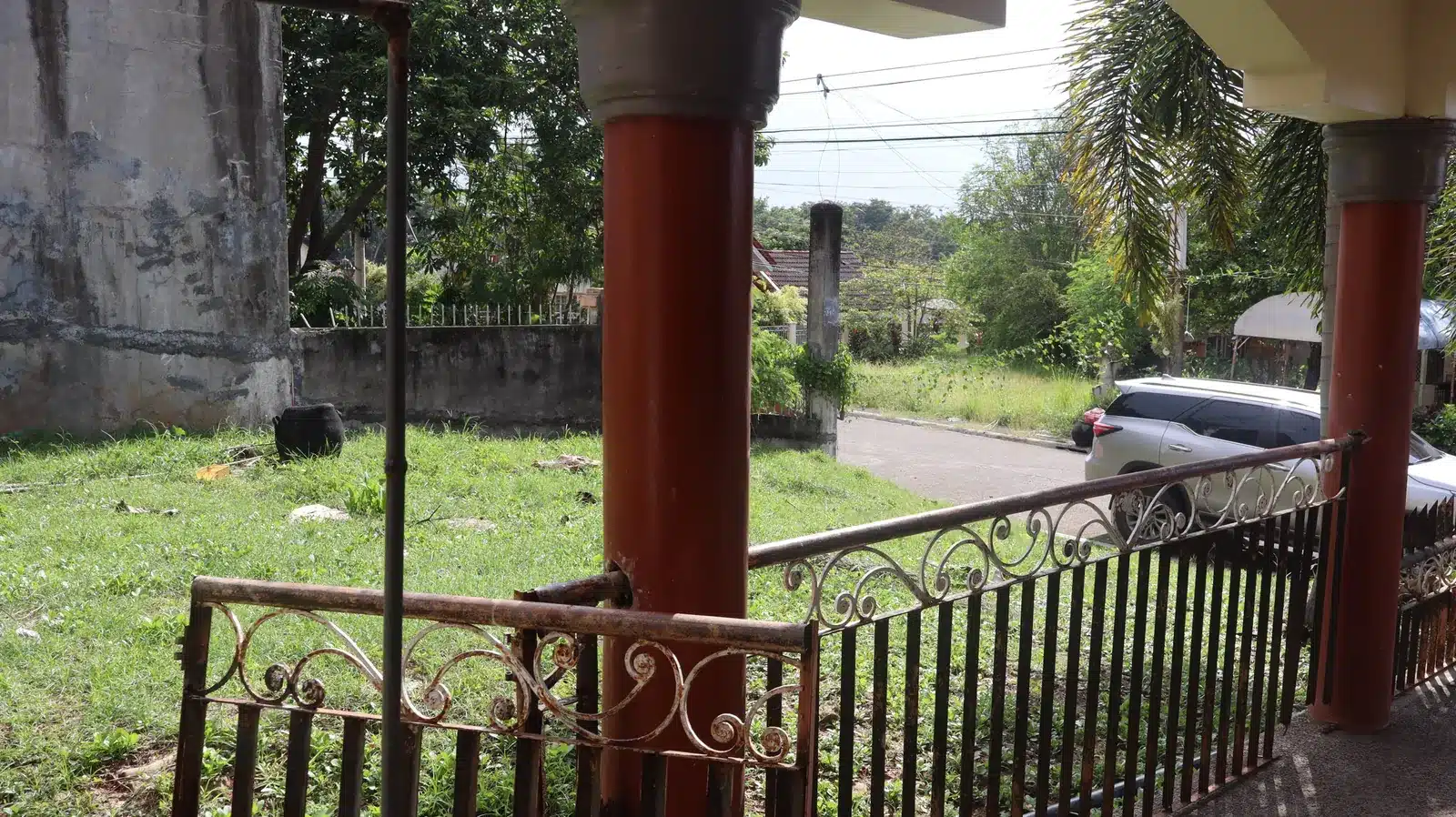

Exterior, railings and stairs

Porch, carport and utility areas

Interior details and inclusions

4Renovation Plan, Budget, and Sequence
Order of work matters. Water and electrical come first because everything after them (ceilings, finishes, paint) depends on them being right. Painting first would mean painting twice.
- Roof and fascia repair₱150K – ₱300K2–3 weeks · Depends on scope confirmation
- Electrical upgrade (licensed RME)₱100K – ₱250K1–2 weeks · Before ceilings close
- Termite treatment and wood repair₱50K – ₱150K1–2 weeks · Can run with step 2
- Ceilings, plumbing, general repairs₱150K – ₱300K2–3 weeks · Steps 1–3 complete
- Bathroom renovation (2 bathrooms)₱200K – ₱400K3–4 weeks · After plumbing check
- Interior and exterior repainting₱150K – ₱300K2–3 weeks · All above complete
Some steps overlap, which is why the overall duration is shorter than the sum of the steps.
Approvals. Exterior changes, roofing, and repainting in Camella communities commonly require homeowners’ association approval, and some work may need a building or electrical permit. Confirm Frontiera HOA rules and any special assessments before mobilizing.
What is not in these figures. Furniture, appliances, aircon servicing, landscaping, relocation, transfer taxes and fees (Section 7), and any structural repair that the engineering check may require.
5Indicative Value Range
Comparables (Gran Europa / Lumbia)
Only 3–4 bedroom comparables are used, since they are the closest to this house. Figures are asking prices, not sold prices. Asking prices run above what buyers actually pay.
| Property | Floor area | Lot area | Asking price |
|---|---|---|---|
| 3BR/2BA, built 2022 | 99 sqm | 99+ sqm | ₱7.9M |
| 4BR/3BA | 110–150 sqm | 121–132 sqm | ₱6.5M – ₱8M+ |
The comparable set is small. This house’s verified 165 sqm floor area is larger than both comparables, and we have deliberately not adjusted the range upward for it. The range will be refined with sold-price data from recently completed Gran Europa projects.
How the range is built
| Step | Basis |
|---|---|
| 1. Move-in-ready reference | ₱7.0M – ₱8.0M for a comparable 3–4BR house in Gran Europa / Lumbia |
| 2. Condition adjustment | Less 15–25% for roof and fascia rot, electrical entrance, water stains, bathrooms, termite damage, and cosmetic wear |
| 3. Result of the method | ₱5.25M – ₱6.8M |
| 4. Location | Frontiera’s pool, the master-planned setting, and Lumbia’s uptown position are already reflected in the Gran Europa comparables. No second premium is added. |
| Indicative as-is range | ₱5.5M – ₱6.5M, the central band of the method result |
Because the comparables are asking prices, we deliberately hold the range inside the method result instead of at its edges.
What it means for your total outlay
All-in cost is the purchase price plus the renovation budget of ₱880K – ₱2.0M. The Pag-IBIG payoff is part of the purchase price, not an addition to it. Transfer taxes and fees (Section 7) are additional. The indicative move-in-ready value is ₱7.0M – ₱8.0M.
| If you buy at | All-in cost | Position against ₱7.0M – ₱8.0M move-in-ready value |
|---|---|---|
| ₱5.5M | ₱6.4M – ₱7.5M | Inside or below the range across the full renovation budget |
| ₱6.0M | ₱6.9M – ₱8.0M | Inside the range; the upper end of the budget uses all the headroom |
| ₱6.5M | ₱7.4M – ₱8.5M | Thin: a high-end renovation outcome would exceed the value range |
This is why price discipline matters more than any single repair line.
Uptown context
Gran Europa is a master-planned Camella community in Lumbia with clubhouse, pool, parks, guarded gates, and CCTV. Lumbia sits in the uptown corridor, where retail and institutional development, including SM City CDO Uptown and the Manresa township, has been adding activity. Uptown areas are generally elevated and less flood-prone than downtown, but flood exposure is site-specific. Confirm it for this lot through barangay and city records and the neighbors, rather than relying on area reputation.
6Recommendations for the Buyer
- Make the purchase conditional on specialist verification of the roof structure, electrical service entrance, plumbing, and wall cracks.
- Budget ₱0.9M – ₱2.0M for renovation, including contingency, and net it against the purchase price. The urgent items are your strongest negotiating points.
- Match the 120 sqm lot area to the title and confirm whether it is a corner or interior lot.
- Request the TCT, updated tax declaration, and real property tax clearance. Confirm HOA dues, any special levies, and Frontiera exterior-work rules.
- Get the sale inclusions in writing: aircons, fixtures, cabinets, and connections.
- Have the electrical entrance corrected by a licensed RME and the roof repaired before anyone moves in, ahead of the rainy season.
- Settle the Pag-IBIG payoff and transfer arrangements in writing before paying anything beyond a reservation (Section 7).
- Sequence the works as in Section 4 so nothing is done twice.
7Title Transfer: Pag-IBIG-Mortgaged Property
The seller acquired this property through a Pag-IBIG housing loan, and the mortgage is still in place with an outstanding balance of approximately ₱1.0M, to be confirmed by a Pag-IBIG statement of account. This is manageable and common, but it changes how payment, title, and transfer costs must be handled. We set it out so nothing surprises you later.
How the transfer works
1 · Payoff figure
2 · Payment structure
3 · Release of mortgage
4 · Deed of Absolute Sale
5 · Taxes, fees, and new title
Precautions we recommend
- Put the cost allocation in writing. By default, capital gains tax and documentary stamp tax fall on the seller by law. If you are shouldering them, the deed or contract must say so, to avoid disputes at signing.
- Budget transfer costs as a separate line from the renovation. When the buyer absorbs everything, this is commonly around 8–10% of the higher of the selling price or the government zonal / fair market value. Ask your lawyer for a written computation.
- Have a lawyer review the contract and handle the transfer. JMG is a construction and design-build firm, not a law firm; this section is a practical outline, and Pag-IBIG’s current rules and counsel’s advice govern.
- Do not release the full balance to the seller until the Pag-IBIG payoff is documented as settled. Keep receipts and the release of mortgage in your file.
- Decide whose name goes on the title before the deed is drafted. If you will sign from abroad, arrange a Special Power of Attorney executed before the Philippine consulate or apostilled, well ahead of the signing date.
- Obtain the real property tax clearance, HOA clearance and dues status, and final utility readings at turnover.
- Do not start renovation until the deed is signed and possession is turned over, unless the seller consents in writing to earlier access.
- List every inclusion in the deed, including the aircons and fixtures we observed on site.
8Remaining Verifications
| Item | Why it matters |
|---|---|
| Lot position | Corner lots typically carry a premium over interior lots. |
| Title and tax documents | TCT (matching the 120 sqm lot), updated tax declaration, real property tax clearance. |
| Pag-IBIG statement | Current payoff amount and the branch’s requirements for release of the mortgage. |
| HOA status | Dues, pending assessments, exterior-work approval rules. |
| Roof structure | Extent of rot in eaves and framing sets the roof budget. |
| Electrical service entrance | Licensed RME to verify compliance and scope of correction. |
| Structural check | Confirms wall cracks are cosmetic, not structural movement. |
| Plumbing and bathrooms | Pressure test and moisture check before finishes are ordered. |
| Flood exposure and inclusions | Confirm lot-level exposure; document what is included in the sale. |
9Recommended Next Step
The purpose of this report is to keep you from committing on incomplete information. The sensible sequence from here:
- Specialist verificationLicensed RME, roof structure, plumbing, structural check. Hidden conditions confirmed; renovation scope and figures tightened; this report reissued as final.
- Scoped renovation proposal and BOQ under JMG Design & BuildA fixed scope, sequence, timeline, and price for the works, so your renovation budget is a number, not a range.
- Negotiation and turnover supportVerified findings translated into a documented price position, and a punch list and handover walk-through at turnover.
You decide at each step. Nothing after Step 1 is committed until you are satisfied with what Step 1 shows.
10Scope and Limitations
This report is based on JMG’s on-site inspection of 27 September 2026 and photographs taken during the visit. It involved visual inspection and measurement of floor and lot areas, and no destructive or instrument testing. Findings on the roof structure, electrical system, plumbing, and wall cracks are visual observations, not engineering or electrical certifications. Values are indicative ranges and renovation costs are estimates; both depend on the verification items in Section 8. This document is not an appraisal and must not be used for bank, legal, or tax purposes. Market comparables are asking prices as of the report date and may change.
JMG CONSTRUCTION & GENERAL MERCHANDISE · operating as JMG Design & Build · Report No. JMG-CA-2026-09-RR01
